Remediation Agreement Template

Free Word download • Edit online • Save & share with Drive • Export to PDF

6 pages25–35 min to fillDifficulty: ComplexSignature requiredLegal review recommended
Learn more ↓

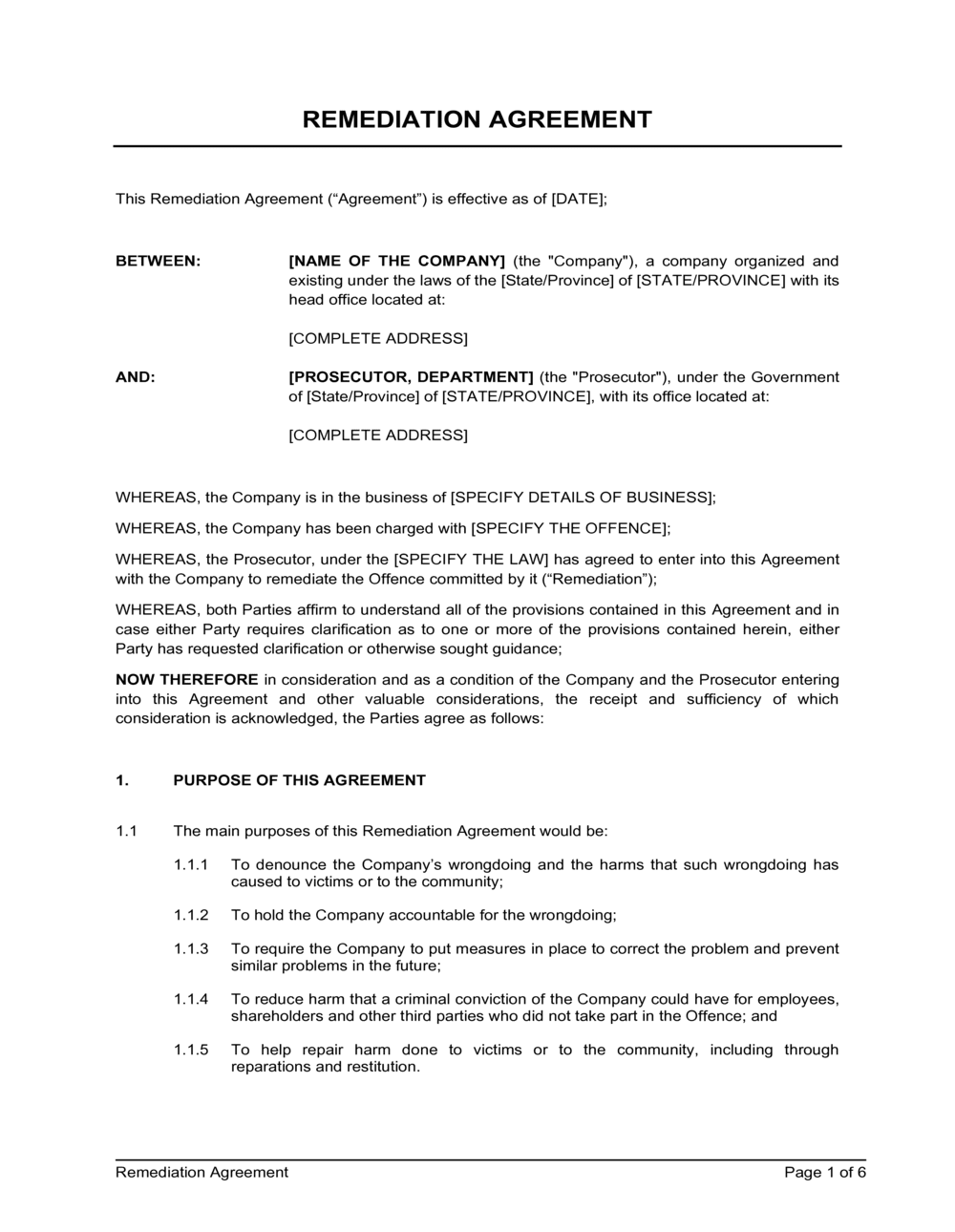

FreeRemediation Agreement Template

At a glance

What it is
A Remediation Agreement is a legally binding contract between two or more parties — typically a responsible party and a regulator, property owner, lender, or counterparty — that formalizes the scope, timeline, standards, and financial responsibility for correcting a defined condition such as environmental contamination, building code violations, data security failures, or regulatory non-compliance. This free Word download gives you a structured, attorney-ready starting point you can edit online and export as PDF.
When you need it
Use it when one party has caused or is responsible for a condition that must be corrected and both parties need a written, enforceable record of exactly what will be fixed, by when, to what standard, and at whose cost. Common triggers include property transactions with known contamination, regulatory enforcement actions, lender-required site cleanups, and post-breach cybersecurity corrective-action plans.
What's inside
Identification of the parties and the affected site or system, a detailed scope of remediation work, performance standards and completion criteria, a milestone-based timeline, cost allocation and payment terms, regulatory reporting obligations, indemnification and liability caps, default and enforcement provisions, and governing law.

What is a Remediation Agreement?

A Remediation Agreement is a legally binding contract between two or more parties that formally documents the scope, timeline, performance standards, cost allocation, and enforcement mechanisms for correcting a defined condition — most commonly environmental contamination, construction defects, cybersecurity vulnerabilities, or regulatory compliance failures. Unlike a regulatory notice or a verbal commitment, a signed remediation agreement creates directly enforceable obligations: it specifies exactly what work will be done, by whom, to what measurable standard, by when, and at whose expense — along with what happens if any party fails to perform. The document typically incorporates a detailed technical remediation action plan as a schedule, preserving the legal clarity of the main contract while allowing the technical scope to be updated without amending the governing terms.

Why You Need This Document

Without a written remediation agreement, the practical question of who bears the cost and responsibility for corrective work remains unanswered until a dispute forces the issue — by which time contamination has spread, regulatory penalties have compounded, or a data breach window has remained open for months. Property buyers who close without one inherit cleanup liability they assumed the seller would cover. Counterparties who rely on verbal commitments discover that "we'll handle it" means nothing when a responsible party becomes insolvent or changes personnel. Even a well-intentioned responsible party benefits from a written agreement: it freezes the scope at a negotiated point, caps cost exposure, and creates a clear path to regulatory closure and liability discharge. This template gives you a professionally structured starting point that covers every material element — scope, performance standards, milestones, financial assurance, step-in rights, and governing law — so the agreement you sign reflects the deal you actually made.

Which variant fits your situation?

If your situation is…Use this template
Cleaning up a contaminated property before a real estate saleEnvironmental Remediation Agreement
Correcting building code or construction deficiencies on a completed projectConstruction Defect Remediation Agreement
Requiring a vendor to fix data security vulnerabilities after a breachCybersecurity Remediation Agreement
Resolving a regulatory enforcement finding without litigationConsent Order / Consent Decree
Allocating cleanup costs between a buyer and seller in a property transactionEnvironmental Indemnity Agreement
Documenting ongoing monitoring obligations after active remediation is completeEnvironmental Monitoring Agreement
Addressing employee or contractor workplace safety violationsCorrective Action Plan Agreement

Common mistakes to avoid

❌ Vague scope language that omits disposal and off-site obligations

Why it matters: If the agreement says 'remediate the site' without specifying off-site soil disposal, groundwater treatment, or third-party monitoring, the responsible party can argue those items are outside their obligation — leaving the counterparty to absorb the cost.

Fix: Attach a detailed Remediation Action Plan as a schedule and expressly incorporate it by reference. List excluded items explicitly so there is no ambiguity about what is and is not covered.

❌ No independent verification of completion

Why it matters: Allowing the responsible party to self-certify completion creates a conflict of interest. A party motivated to minimize cost can submit lab results that barely meet the threshold or cherry-pick sampling locations.

Fix: Require a third-party consultant nominated by the counterparty, or a written regulatory closure letter, as the binding completion standard. Build the cost of third-party verification into the cost-allocation clause.

❌ Omitting financial assurance for long or high-cost remediations

Why it matters: If the responsible party defaults or becomes insolvent mid-project, the counterparty is left with an incomplete remediation and must fund the work themselves or pursue litigation with uncertain recovery.

Fix: Require a letter of credit or escrow account equal to 110–125% of the estimated remediation cost, delivered before field work begins and maintained until written confirmation of completion.

❌ No step-in right for the counterparty upon default

Why it matters: Without a contractual step-in right, the counterparty's only remedy for non-performance is litigation — which can take years while contamination spreads, regulatory penalties accrue, or a security breach window remains open.

Fix: Include a step-in clause that allows the counterparty to hire replacement contractors and draw on financial assurance after a short notice-and-cure period, with any cost excess due from the responsible party.

❌ Governing law that does not match the site jurisdiction

Why it matters: Environmental cleanup obligations, data protection requirements, and building codes are location-specific. A governing law clause pointing to a different state or country can create conflicts with mandatory local regulations that apply regardless.

Fix: Set the governing law to the jurisdiction where the site is located or where the responsible party's obligations under the applicable regulation arise. Add a choice-of-law carve-out for mandatory local provisions if the parties are from different jurisdictions.

❌ No regulatory reporting cooperation clause

Why it matters: If the responsible party files regulatory submissions without counterparty review, they may commit to narrower cleanup standards or different timelines than the agreement requires — binding both parties to terms the counterparty never approved.

Fix: Require the responsible party to provide the counterparty with draft regulatory submissions at least 5 business days before filing, with a right to comment, and copies of all agency responses within 5 business days of receipt.

The 10 key clauses, explained

Parties, recitals, and defined terms

In plain language: Identifies every party by full legal name, describes the background circumstances that created the remediation obligation, and defines key terms used throughout the agreement.

Sample language
This Remediation Agreement ('Agreement') is entered into as of [DATE] by and between [RESPONSIBLE PARTY LEGAL NAME], a [STATE] [ENTITY TYPE] ('Responsible Party'), and [COUNTERPARTY LEGAL NAME] ('Counterparty'). RECITALS: A. The Responsible Party owns or operates the property located at [ADDRESS] ('Site'). B. Sampling conducted on [DATE] identified [CONTAMINANT / CONDITION] at the Site requiring remediation under [APPLICABLE LAW / PERMIT].

Common mistake: Using trade names instead of registered legal entity names. A mismatch between the agreement and corporate registry records can make indemnification and enforcement clauses difficult to pursue against the right entity.

Scope of remediation work

In plain language: Defines precisely what physical, technical, or corrective actions will be performed — referencing the Remediation Action Plan attached as a schedule — and confirms what is explicitly excluded.

Sample language
Responsible Party shall perform all remediation activities described in the Remediation Action Plan attached hereto as Exhibit A ('RAP'), including [EXCAVATION / GROUNDWATER TREATMENT / SYSTEM PATCHING / OTHER SPECIFIC ACTIONS]. Activities not listed in the RAP are excluded from this Agreement unless added by written amendment.

Common mistake: Describing the scope only in general terms such as 'cleanup of the site.' Vague scope language leads to disputes about whether specific tasks — such as off-site soil disposal or third-party monitoring — are included.

Performance standards and completion criteria

In plain language: States the measurable benchmarks the remediation must achieve and the specific tests or certifications that confirm it is done.

Sample language
Remediation shall be deemed complete when: (a) soil concentrations of [CONTAMINANT] at the Site are at or below [X] mg/kg as confirmed by [LABORATORY / TESTING STANDARD]; and (b) the applicable regulatory agency issues written No Further Action ('NFA') determination, or Counterparty's independent consultant confirms compliance with the standards in Exhibit B.

Common mistake: Tying completion solely to the responsible party's own testing. An independent verification step — whether by a third-party consultant or regulatory closure letter — protects the counterparty and is standard in most professionally drafted agreements.

Milestone timeline and schedule

In plain language: Sets binding deadlines for each phase of the remediation — design, permitting, active cleanup, sampling, and final reporting — with consequences for missing them.

Sample language
Responsible Party shall complete each milestone by the dates set out in Exhibit C. If any milestone is missed by more than [30] calendar days, Responsible Party shall notify Counterparty in writing within [5] business days, provide a revised schedule, and pay a delay fee of $[AMOUNT] per day until the milestone is achieved.

Common mistake: No cure period or notice requirement before a delay triggers default. Courts often decline to enforce immediate-default clauses for minor delays; building in a 5–10 day notice-and-cure window is both more enforceable and commercially reasonable.

Cost allocation and payment terms

In plain language: Establishes who pays for each element of the remediation, how invoices are submitted, when payment is due, and how cost overruns beyond the agreed budget are handled.

Sample language
Responsible Party shall bear all costs of remediation up to $[CAP AMOUNT]. Costs exceeding the cap require written approval from both parties before being incurred. Invoices for reimbursable costs shall be submitted monthly with supporting receipts and paid within [30] days of receipt.

Common mistake: No cost cap or overrun approval mechanism. Without one, the responsible party can run up costs and present the counterparty with an unexpected bill, or the counterparty can demand gold-plated solutions that exceed what was commercially agreed.

Financial assurance

In plain language: Requires the responsible party to provide a financial instrument — escrow, letter of credit, or surety bond — guaranteeing that funds exist to complete the work if they default.

Sample language
Within [15] business days of execution, Responsible Party shall deliver to Counterparty a clean, irrevocable letter of credit in the amount of $[AMOUNT] issued by a bank acceptable to Counterparty, in substantially the form of Exhibit D. The letter of credit shall remain in force until Counterparty delivers written notice of satisfactory completion.

Common mistake: Omitting financial assurance for long-duration or high-cost remediations. If the responsible party becomes insolvent mid-project, the counterparty is left with an unfinished site and no practical recourse.

Regulatory reporting and cooperation

In plain language: Requires the responsible party to file all regulatory reports, permit applications, and agency notifications on schedule, and to include the counterparty on all material communications.

Sample language
Responsible Party shall submit all reports, work plans, and correspondence required under [APPLICABLE REGULATIONS] to the [AGENCY NAME] by the deadlines set out in Exhibit C. Counterparty shall receive copies of all regulatory submissions and agency responses within [5] business days of submission or receipt.

Common mistake: Granting the counterparty no right to review regulatory submissions before they are filed. A submission that contains errors or commits to narrower standards than the agreement requires can bind both parties.

Indemnification and liability

In plain language: Allocates risk for losses, third-party claims, and penalties — including pre-existing conditions, newly discovered contamination, and personal injury claims arising from the remediation work itself.

Sample language
Responsible Party shall indemnify, defend, and hold harmless Counterparty from and against any and all claims, damages, penalties, and costs arising out of or related to: (a) Responsible Party's failure to perform the RAP; (b) pre-existing contamination at the Site; and (c) Responsible Party's performance of remediation activities, except to the extent caused by Counterparty's gross negligence or willful misconduct.

Common mistake: No carve-out for pre-existing unknown contamination. Without it, the responsible party may argue that newly discovered contamination found during cleanup was not part of their agreed scope, creating a coverage gap.

Default, cure, and enforcement

In plain language: Defines what constitutes a default, the notice and cure period, and the remedies available — including the counterparty's right to perform the work themselves and charge costs back.

Sample language
A Default occurs if Responsible Party: (a) fails to meet any milestone by more than [30] days after written notice; (b) fails to maintain required financial assurance; or (c) abandons the work. Upon a Default, Counterparty may, after [10] business days' written notice, hire third-party contractors to complete the remediation and draw on financial assurance to cover all costs, with any excess due from Responsible Party within [30] days.

Common mistake: No step-in right. If the responsible party defaults without a counterparty step-in right, the counterparty must pursue litigation to force performance — a process that can take years while the condition worsens.

Governing law, dispute resolution, and notices

In plain language: Specifies the jurisdiction whose law governs the agreement, how disputes are resolved (arbitration, mediation, or court), and the required form and address for formal notices.

Sample language
This Agreement is governed by the laws of [STATE / PROVINCE / COUNTRY]. Any dispute shall first be submitted to non-binding mediation before [MEDIATION PROVIDER] in [CITY]; if not resolved within [45] days, disputes shall be resolved in the courts of [JURISDICTION]. Notices shall be in writing, delivered by overnight courier or email with read-receipt to the addresses set out in Exhibit E.

Common mistake: Choosing a governing law with no connection to where the site or system is located. Many environmental and data-protection obligations are location-specific — the governing law should match the jurisdiction where the condition exists and where regulatory obligations run.

How to fill it out

  1. 1

    Identify all parties by full legal name and role

    Enter each party's registered legal entity name, state or country of formation, and their role — Responsible Party, Property Owner, Lender, or Regulator. Confirm names against current corporate registry filings.

    💡 For multi-party remediations involving both a property owner and a lender, list each party separately and define their respective obligations and consent rights in the body of the agreement.

  2. 2

    Describe the condition requiring remediation in the recitals

    Summarize the factual background: the site or system affected, the nature of the condition (contamination type, security vulnerability, code violation), how it was discovered, and the legal or contractual obligation that requires correction.

    💡 Keep recitals factual and neutral — admissions of wrongdoing in a recital can be used against a party in subsequent litigation or regulatory proceedings.

  3. 3

    Attach a detailed Remediation Action Plan as Exhibit A

    Reference a separately prepared technical document that specifies the exact methods, equipment, sequence of work, disposal protocols, and responsible contractor. Do not embed technical details in the agreement body.

    💡 Have the RAP prepared or reviewed by a licensed environmental consultant, cybersecurity firm, or qualified engineer before execution — vague scope is the single most common source of post-signing disputes.

  4. 4

    Set measurable performance standards and completion criteria

    State numeric cleanup levels, security benchmarks, or inspection pass/fail criteria in Exhibit B. Identify who performs verification testing and what documentation — lab reports, audit certificates, regulatory closure letters — constitutes proof of completion.

    💡 Require an independent third-party to verify completion, not just the responsible party's own consultant. This protects the counterparty and is often required by regulators anyway.

  5. 5

    Build a milestone schedule with notice-and-cure provisions

    List each phase — design, permitting, mobilization, active remediation, post-remediation sampling, final report, regulatory submission — with a specific calendar date. Add a notice-and-cure period (5–10 business days) before any delay becomes a default.

    💡 Build in a 10–15% schedule buffer for permitting delays outside the responsible party's control. Distinguish between excused delays (force majeure, regulatory backlogs) and unexcused delays (resource shortfalls, contractor issues).

  6. 6

    Define cost allocation, cap, and overrun approval

    State whether the responsible party bears all costs or whether costs are shared, set a cost cap if applicable, and require written approval from both parties before the cap is exceeded. Specify invoice format, documentation requirements, and Net 30 payment terms.

    💡 For high-uncertainty remediations where cost overruns are likely, consider a shared-cost mechanism above the cap rather than unlimited responsible-party liability — it keeps incentives aligned.

  7. 7

    Specify the financial assurance instrument and amount

    Choose the financial assurance type (letter of credit, escrow, surety bond), set the amount at 110–125% of the estimated total remediation cost, and name the acceptable issuing institution. Attach the required form as Exhibit D.

    💡 Require the financial assurance to be delivered before the responsible party begins any field work — not just before the first milestone — so funds are available from day one.

  8. 8

    Execute before any field work begins and store fully executed copies

    Both parties must sign before the responsible party mobilizes contractors or begins corrective action. Use a wet signature or a dated electronic signature platform that creates an audit-trail record. Store executed copies in a secure, accessible location.

    💡 Scan and save executed agreements alongside the RAP and all exhibits in a single folder — regulatory agencies and future property buyers will request the full package together.

Frequently asked questions

What is a remediation agreement?

A remediation agreement is a legally binding contract that formalizes the obligations of one or more parties to correct a defined condition — environmental contamination, building defects, cybersecurity vulnerabilities, or regulatory violations. It specifies the scope of corrective work, performance standards, timeline, cost allocation, financial assurance, and enforcement mechanisms. Unlike a verbal commitment or a regulatory notice alone, a signed remediation agreement creates directly enforceable rights between the parties.

When do I need a remediation agreement?

Common triggers include a real estate transaction involving a contaminated property, a regulatory inspection that identifies violations requiring correction, a data breach where a vendor must fix security gaps, or a construction defect discovered after project completion. Any time one party is responsible for correcting a condition and another party needs assurance that the work will be done to a defined standard, a remediation agreement is the appropriate document.

What is the difference between a remediation agreement and a consent order?

A consent order is a formal agreement between a government regulatory agency and a regulated entity that carries the force of an administrative order — violation can result in agency-imposed penalties without a court proceeding. A private remediation agreement operates between non-governmental parties and is enforced through contract law. In many situations both documents coexist: a consent order governs the regulatory relationship, and a private remediation agreement allocates costs and obligations between the property owner and a responsible third party.

Who is the responsible party in a remediation agreement?

The responsible party is the individual or entity legally obligated to fund and carry out the remediation. In environmental contexts, this is typically determined by the applicable statute — for example, CERCLA in the US imposes liability on current and former site owners, operators, and parties who arranged for disposal of hazardous substances. In commercial disputes, the responsible party is whoever contractually caused or contributed to the condition requiring correction. Identifying the correct responsible party is critical because obligations that attach to the wrong entity are difficult to enforce.

Is financial assurance always required in a remediation agreement?

Financial assurance is not legally required in every private remediation agreement, but it is strongly recommended for any remediation expected to cost more than $50,000 or last longer than six months. Many regulatory programs — including RCRA corrective action in the US and similar regimes in Canada and the EU — independently require financial assurance as a condition of a cleanup permit. From a counterparty's perspective, proceeding without financial assurance means that if the responsible party defaults or becomes insolvent, the counterparty absorbs the remaining cost with no practical recourse.

How are remediation costs typically allocated between parties?

Cost allocation depends on the nature of the condition and the parties' relative contributions to it. In environmental property transactions, the seller often retains liability for pre-closing contamination up to a negotiated cost cap, with the buyer taking responsibility for any overruns or post-closing discoveries. In regulatory enforcement contexts, the regulated party bears the full cost. In construction defect disputes, costs may be shared between the owner and contractor based on fault. Always define a cost cap, an overrun approval process, and a shared-cost mechanism in writing — never leave cost exposure open-ended.

Can a remediation agreement limit liability?

Yes — parties commonly include mutual liability caps (often tied to the total contract value), carve-outs for gross negligence and willful misconduct, and indemnification provisions that allocate specific categories of risk. However, liability limitations in remediation agreements cannot override statutory obligations imposed by environmental or data-protection law. In the US, for example, CERCLA liability to the government cannot be contractually eliminated — though it can be allocated between private parties. Consider consulting a lawyer to confirm that any liability cap does not conflict with mandatory legal requirements in the applicable jurisdiction.

What happens if the responsible party fails to complete the remediation?

If the responsible party defaults, a well-drafted agreement gives the counterparty the right to: (1) draw on the financial assurance instrument to fund completion; (2) hire replacement contractors directly; (3) pursue the responsible party for any cost difference; and (4) seek injunctive relief to compel performance. Without these contractual remedies, the counterparty is limited to suing for breach of contract — a process that can take years while regulatory penalties accumulate and the condition worsens. A step-in right, backed by financial assurance, is the most effective practical protection.

Do I need a lawyer to draft a remediation agreement?

For straightforward corrective-action arrangements between two commercial parties, a detailed template provides a solid starting point. A lawyer is strongly recommended when regulatory agencies are parties or when the agreement must interface with a consent order; when the remediation cost exceeds $250,000; when the agreement involves multiple responsible parties or third-party indemnities; or when cross-border obligations are involved. Environmental and data-protection remediation agreements in particular involve statutory liability frameworks that require jurisdiction-specific legal knowledge to navigate correctly.

How this compares to alternatives

vs Environmental Indemnity Agreement

An environmental indemnity agreement shifts financial risk for future environmental liabilities from one party to another — typically from a lender to a borrower — but does not itself require that any cleanup be performed. A remediation agreement imposes an affirmative obligation to perform corrective work to a defined standard. The two documents frequently coexist in property transactions: the indemnity addresses ongoing risk allocation while the remediation agreement governs the actual cleanup.

vs Consent Order

A consent order is a formal regulatory instrument between a government agency and a regulated entity, enforceable as an administrative order with statutory penalty authority. A remediation agreement is a private contract enforced through civil litigation. In many situations, both exist simultaneously: the consent order governs regulatory compliance, and the remediation agreement handles cost-sharing and performance obligations between private parties.

vs Settlement Agreement

A settlement agreement resolves an existing dispute by defining what each party will do or pay to end the litigation or claim — it is backward-looking. A remediation agreement is forward-looking: it defines ongoing performance obligations, milestones, and consequences for non-performance. A settlement agreement may contain remediation obligations, but a standalone remediation agreement is the appropriate document when the primary purpose is governing corrective-action performance rather than resolving a past claim.

vs Service Agreement

A service agreement governs a commercial relationship between a client and a contractor providing general services for compensation. A remediation agreement is specifically structured around a defined condition that must be corrected to a regulatory or contractual standard, and includes elements — financial assurance, performance standards, step-in rights, and regulatory reporting obligations — that standard service agreements do not address.

Industry-specific considerations

Real Estate and Property Development

Contaminated-site transactions routinely require a remediation agreement as a condition of closing, allocating pre-closing and post-closing cleanup obligations between buyer and seller with a defined cost cap and escrow.

Construction and Engineering

Defective construction agreements address structural, mechanical, or code-compliance failures discovered post-completion, specifying which contractor performs corrections, the timeline, and whether performance bonds are drawn.

Technology and Cybersecurity

Following a data breach or audit finding, remediation agreements bind vendors to a specific patching schedule, penetration-testing verification, and ongoing monitoring obligations — with contractual consequences for missing deadlines.

Manufacturing and Industrial Operations

Industrial sites with legacy soil or groundwater contamination use remediation agreements to allocate costs between current owners, former operators, and insurers, often running alongside state voluntary cleanup programs.

Jurisdictional notes

United States

Federal environmental remediation is primarily governed by CERCLA (Superfund) and RCRA, with EPA oversight. Most states operate their own voluntary cleanup programs with liability-release provisions for qualifying remediations. Non-compete and indemnification clauses in remediation agreements may be subject to state-specific enforceability rules. California, New Jersey, and Massachusetts have particularly stringent state environmental statutes that impose obligations independent of any private agreement.

Canada

Environmental remediation obligations are primarily governed by provincial legislation — notably the Ontario Environmental Protection Act, British Columbia's Environmental Management Act, and Alberta's Environmental Protection and Enhancement Act. Quebec has a distinct civil-law framework that affects indemnification clause interpretation. Federal CEPA jurisdiction applies to certain federal lands and interprovincial matters. Financial assurance requirements vary significantly by province and are often tied to certificate-of-approval conditions.

United Kingdom

Contaminated land remediation in England and Wales is primarily regulated under Part IIA of the Environmental Protection Act 1990, administered by local authorities and the Environment Agency. Scotland and Northern Ireland operate under separate but analogous regimes. Post-Brexit, UK data protection remediation obligations are governed by UK GDPR and the Data Protection Act 2018. Remediation agreements connected to planning consents must align with planning conditions and may require local authority approval.

European Union

The EU Environmental Liability Directive (2004/35/EC) establishes a preventive and remedial framework for environmental damage, with member states implementing it through national legislation that varies in scope and enforcement. GDPR Article 32 imposes specific technical and organizational remediation obligations following personal data breaches, and agreements binding processors to corrective action must align with processor agreement requirements under Article 28. Member state variations — particularly between Germany, France, and the Netherlands — are significant enough to require local counsel for any cross-border remediation arrangement.

Template vs lawyer — what fits your deal?

PathBest forCostTime
Use the templateTwo-party corrective-action arrangements under $100,000 with no regulatory agency involvement and no cross-border obligationsFree1–2 hours
Template + legal reviewCommercial property transactions, vendor cybersecurity remediation plans, or any arrangement where a regulator's acceptance may be required$500–$1,500 for a lawyer review of the completed template3–5 business days
Custom draftedHigh-value or multi-party remediations, consent-order-linked cleanups, CERCLA or RCRA corrective-action programs, or agreements requiring agency approval$3,000–$15,000+ depending on complexity and jurisdiction2–6 weeks

Glossary

Responsible Party
The individual or entity legally obligated to fund and execute the remediation — typically the party who caused or contributed to the condition requiring correction.
Remediation Action Plan (RAP)
A written technical document, often attached as a schedule, describing the specific methods, equipment, and sequence of work to achieve cleanup.
Performance Standard
A measurable threshold — such as a regulatory cleanup level in parts per million, or a CVSS security score — that the remediation must reach to be considered complete.
Completion Criteria
The specific tests, inspections, or certifications that must be passed before the remediation is formally declared finished and obligations discharged.
Financial Assurance
A mechanism — such as a letter of credit, surety bond, or escrow account — that guarantees funds are available to complete remediation if the responsible party defaults.
Regulatory Closure
A written determination from the applicable regulatory agency that the site or system meets cleanup standards and no further action is required.
Indemnification
A contractual obligation by one party to compensate the other for losses, claims, or costs arising from specified events — such as undiscovered contamination beyond the agreed scope.
Force Majeure
A clause excusing a party from performance obligations caused by events outside their reasonable control, such as natural disasters or government-ordered shutdowns.
Monitoring Period
A defined window — often 1–5 years after active remediation — during which groundwater, soil, or system metrics are sampled to confirm the remedy remains effective.
Consent Order
A formal agreement between a regulatory agency and a regulated party that incorporates remediation obligations and carries the legal force of an administrative order.
Material Breach
A failure by one party to perform an obligation significant enough to justify the other party suspending performance, demanding cure, or terminating the agreement.

Part of your Business Operating System

This document is one of 3,000+ business & legal templates included in Business in a Box.

  • Fill-in-the-blanks — ready in minutes
  • 100% customizable Word document
  • Compatible with all office suites
  • Export to PDF and share electronically

Create your document in 3 simple steps.

From template to signed document — all inside one Business Operating System.
1
Download or open template

Access over 3,000+ business and legal templates for any business task, project or initiative.

2
Edit and fill in the blanks with AI

Customize your ready-made business document template and save it in the cloud.

3
Save, Share, Send, Sign

Share your files and folders with your team. Create a space of seamless collaboration.

Save time, save money, and create top-quality documents.

★★★★★

"Fantastic value! I'm not sure how I'd do without it. It's worth its weight in gold and paid back for itself many times."

Managing Director · Mall Farm
Robert Whalley
Managing Director, Mall Farm Proprietary Limited
★★★★★

"I have been using Business in a Box for years. It has been the most useful source of templates I have encountered. I recommend it to anyone."

Business Owner · 4+ years
Dr Michael John Freestone
Business Owner
★★★★★

"It has been a life saver so many times I have lost count. Business in a Box has saved me so much time and as you know, time is money."

Owner · Upstate Web
David G. Moore Jr.
Owner, Upstate Web

Run your business with a system — not scattered tools

Stop downloading documents. Start operating with clarity. Business in a Box gives you the Business Operating System used by over 250,000 companies worldwide to structure, run, and grow their business.

Free Forever Plan · No credit card required
